TABLE OF CONTENTS
Construction Activities undertaken during the Reporting Month
Statues of Environmental Licensing and Permitting
Monitoring Parameters, Frequency and Duration
Monitoring Methodology and QA/QC Procedure
Monitoring Parameters, Frequency and Duration
Monitoring Methodology and QA/QC Procedure
Implementation Status of Environmental Mitigation Measures
Implementation Status of Event and Action Plans
Summary of Complaint, Warning, Notification of any Summons and Successful Prosecution
Monitoring Schedule for Next Month
lIST OF TABLES
Table I............... Summary of Complaint/Summons/Prosecution in the Reporting Month
Table 1.1............ Key Project Contacts
Table 1.2............ Summary of Environmental Licensing and Permit Status
Table 2.1 ........... Locations for Air Quality Monitoring
Table 2.2 ........... Air Quality Monitoring Equipment
Table 2.3 ........... Impact Dust Monitoring Parameters, Frequency and Duration
Table 3.1 ........... Noise Monitoring Stations
Table 3.2 ........... Noise Monitoring Equipment
Table 3.3 ........... Noise Monitoring Parameters, Frequency and Duration
Table 3.4 ........... Baseline Noise Level and Noise Limit Level for Monitoring Stations
Table 4.1............ Quantities of Waste Generated from the Project
Table 6.1............ Observations and Recommendations of Site Inspections
Table 6.2............ Status of Required Submission under Environmental Permit
lIST OF FIGUREs
Figure 2 Project Organisation for Environmental Monitoring and Audit
Figure 3 Location of Monitoring Station
lIST OF APPENDIces
Appendix A Action and Limit Levels for Air Quality and Noise
Appendix B Copies of Calibration Certificates
Appendix C Weather Information
Appendix D Environmental Monitoring Schedules
Appendix E 1-hour TSP Monitoring Results and Graphical Presentations
Appendix F 24-hour TSP Monitoring Results and Graphical Presentations
Appendix G Noise Monitoring Results and Graphical Presentations
Appendix H Summary of Exceedance
Appendix J Environmental Mitigation Implementation Schedule (EMIS)
Appendix L Summary of Waste Generation and Disposal Records
Appendix M Construction Programme
Introduction
1. This is the 1st Monthly Environmental Monitoring and Audit (EM&A) Report prepared by the Environmental Team (ET), Cinotech Consultants Ltd., for Contract No. HY/2019/13 “Central Kowloon Route – Buildings, Electrical and Mechanical Works”. This report summarized the monitoring results and audit findings of the EM&A programme under the issued EP No. EP-457/2013/D, and in accordance with the EM&A programme in Central Tunnel (Ho Man Tin Area) during the reporting period from 1st January 2024 – 31st January 2024.
2. The major site activities undertaken in Central Tunnel (Ho Man Tin Area) in the reporting month included:
Environmental Monitoring Works
3. Environmental monitoring for the Project was performed in accordance with the EM&A Manual and the monitoring results were checked and reviewed. Joint weekly site inspections with the representative of ET, Engineer Representative and the Contractor for for Contract No. HY/2019/13 were conducted on 2, 9, 16, 23, 30 January 2024, whereas joint site inspection with the representative of IEC was conducted on 9 January 2024. The implementation of the environmental mitigation measures, Event and Action Plans and environmental complaint handling procedures were also checked.
4. A summary of the non-compliance (exceedance) during the reporting month (January 2024) and the investigation results and/or follow-up actions is provided below:
Complaint Handling, Prosecution and Public Engagement
5. Summary of complaint/summons/prosecution in the reporting month is tabulated in Table I.
Event |
Event Details |
Follow-up/ Remedial Actions |
Status/ Remarks |
||
Number |
Brief Description |
||||
Complaints Received |
0 |
- |
- |
- |
|
Notification of Summons and Prosecutions Received |
0 |
- |
- |
- |
|
Reporting Changes
6. There were no reporting changes during the reporting month.
Future Key Issues
7. The key works or activities will be anticipated in the coming two months are as follows:
Party |
Role |
Contact Person |
Phone No. |
AMMJV |
Engineer Representative |
Mr. Tommy Wong |
3695 0419 |
Cinotech |
Environmental Team |
Ms. Betty Choi |
2151 2072 |
ERM |
Independent Environmental Checker |
Ms. Mandy To |
2271 3113 |
GCL |
Contractor |
Mr. Sampson Lo |
9752 9118 |
Permit / License No. |
Valid Period |
Status |
|
From |
To |
||
Environmental Permit (EP) |
|||
EP-457/2013/D |
15 Jun 2021 |
N/A |
Valid |
Notification of Construction Works under Air Pollution Control Ordinance (APCO) |
|||
457345 |
19 Jun 2020 |
End of Project |
Valid |
Billing Account for Construction Waste Disposal |
|||
7037679 |
26 Jun 2020 |
N/A |
Valid |
Registration of Chemical Waste Producer – Ho Man Tin |
|||
5213-236-G2347-61 |
28 Nov 2023 |
N/A |
Valid |
Wastewater Discharge Licence - Ho Man Tin |
|||
498618 |
N/A |
N/A |
Under payment process |
Construction Noise Permit - Ho Man Tin |
|||
GW-RE0016-24 |
14 Jan 2024 |
13 Apr 2024 |
Valid |
Monitoring Stations |
Locations |
Location of Measurement |
M-A3 |
S.K.H. Tsoi Kung Po Secondary School |
Rooftop (about 3/F) Area |
Equipment |
Model and Make |
Quantity |
Calibrator |
TISCH TE-5025A |
1 |
1-hour TSP Dust Meter |
Dust Monitor System OC-9200 |
1 |
High Volume Sampler |
TE-5170 c/w of TSP sampling inlet |
1 |
Wind Anemometer |
C-OC-9200-wind |
1 |
Parameters |
Frequency |
1-hour TSP |
Three times / 6 days |
24-hour TSP |
Once / 6 days |
Monitoring Stations |
Locations |
Location of Measurement |
M-N3 |
S.K.H. Tsoi Kung Po Secondary School |
Rooftop (about 3/F) Area |
Equipment |
Model and Make |
Quantity |
Calibrator |
SOUNDTEK ST-120 |
1 |
Integrating Sound Level Meter |
BSW Atech BSWA 308 & SVAN 979 |
1 |
Monitoring Stations |
Parameter |
Period |
Frequency |
Measurement |
M-N3 |
L10(30 min.) dB(A) L90(30 min.) dB(A) Leq(30 min.) dB(A) |
0700-1900 hrs on normal weekdays |
Once per week |
Façade |
Monitoring Stations |
Baseline Noise Level, dB (A) |
Noise Limit Level, dB (A) |
M-N3 |
67.7(1) (at 0700 – 1900 hrs on normal weekdays) |
70(*) (at 0700 – 1900 hrs on normal weekdays) |
(*) Noise Limit Level is 65 dB(A) during school examination periods.
Note (1): The noise level due to the construction work (CNL) was calculated by the following formula:
CNL = 10 log (10MNL/10 – 10BNL/10)
Remarks: MNL = Measured Noise Level, BNL = Baseline Noise Level
Quantity |
|||||||
|
Inert C&D Materials |
Non-inert C&D Materials |
|||||
Reporting Period |
Total Quantity Generated (in '000m3) |
Disposed as Public Fill (in '000m3) |
Others, e.g. general refuse (in '000m3) |
Metals (in '000kg) |
Paper/cardboard Packaging (in '000kg) |
Plastics (in '000kg) |
Chemical waste (in '000kg) |
January 2024 |
0 |
0 |
0.127 |
0 |
0 |
0 |
0 |
Parameters |
Date |
Observations |
Follow-up Actions |
Water Quality |
N/A |
No environmental deficiency was identified in the reporting period. |
N/A |
Air Quality |
N/A |
No environmental deficiency was identified in the reporting period. |
N/A |
Noise |
N/A |
No environmental deficiency was identified in the reporting period. |
N/A |
Waste / Chemical Management |
N/A |
No environmental deficiency was identified in the reporting period. |
N/A |
Land Contamination |
N/A |
No environmental deficiency was identified in the reporting period. |
N/A |
Landscape and Visual |
N/A |
No environmental deficiency was identified in the reporting period. |
N/A |
Permits /Licences |
N/A |
No environmental deficiency was identified in the reporting period. |
N/A |

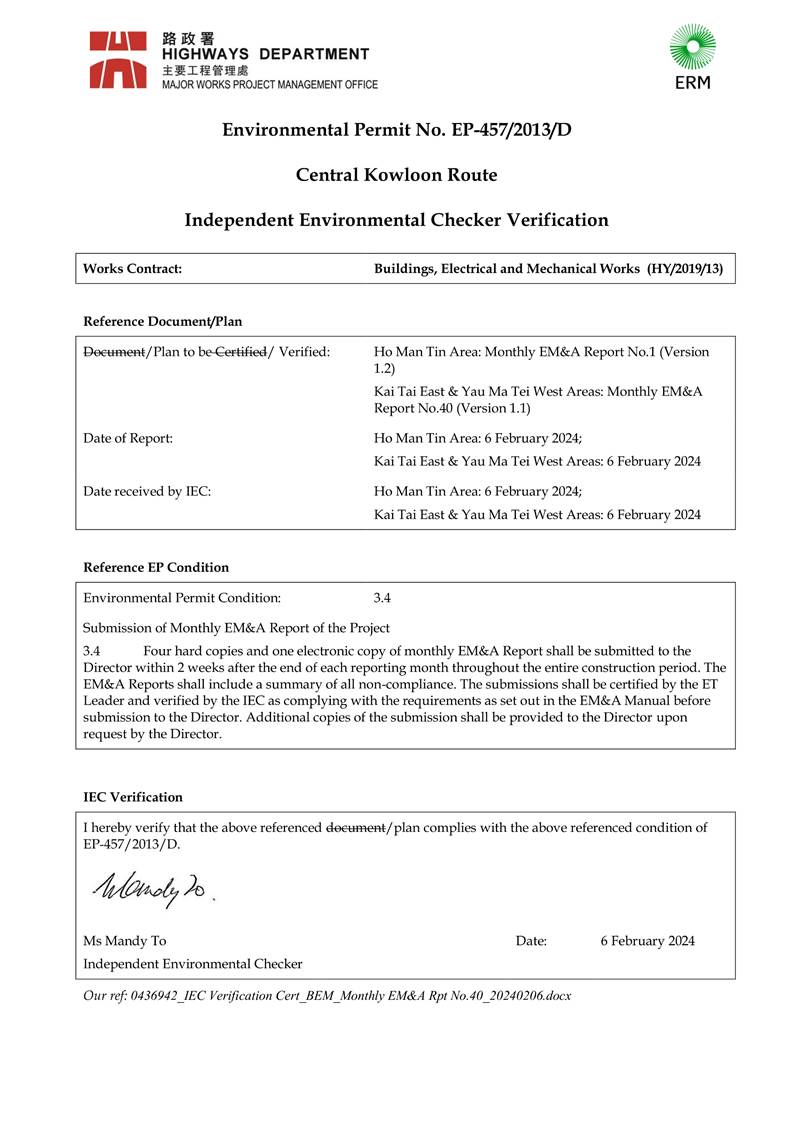

EP Condition (EP-457/2013/D) |
Submission |
Submission Date |
Condition 3.4 |
N/A |
N/A |

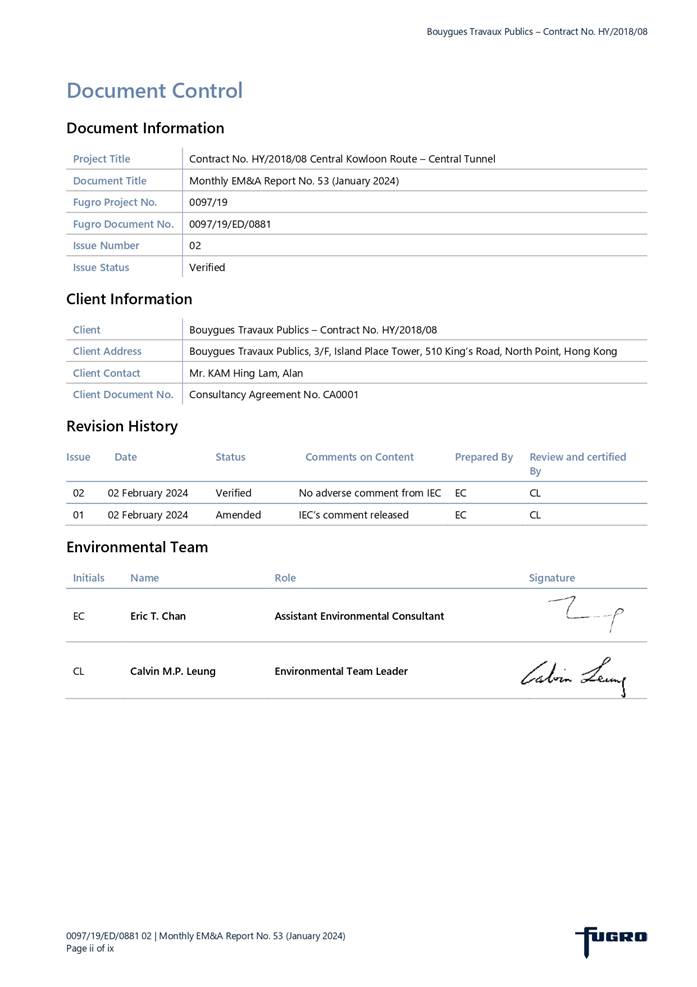

I. Introduction

This is the 53rd Monthly EM&A Report prepared by Fugro Technical Services Limited for the Contract No. HY/2018/08 Central Kowloon Route – Central Tunnel. The Contract No. HY/2018/08 commenced on 19 September 2019. This report summarized the monitoring results and audits findings of the EM&A programme under the issued EP (EP No.: EP-457/2013/D) and in accordance with the EM&A Manual during the reporting period from 01/01/2024 to 31/01/2024.
II. Summary of Main Works Undertaken and Key Measures Implemented
The main construction works carried out in the reporting period were as follow:
Ho Man Tin1
· Underbreak scaling and smoothing works;
· Invert, lining and OHVD construction;
· CLP Room demolition and slope reinstatement.
Yau Ma Tei
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work.
Ma Tau Kok
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Cut and cover construction
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Concreting.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man Tin site surface was substantially completed. The site had been handed over to Contract No. HY/2019/13 on 30 December 2023.
III. Summary of Exceedances, Investigation and Follow-up
The last impact monitoring conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was subsequently conducted by Environmental Team of Contract HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared by Contract No. HY/2019/13.
No Action and Limit Level exceedance was recorded for construction dust monitoring in the reporting month.
One (1) Action Level exceedance was recorded for construction noise due to the noise-related complaints received in the reporting month. No Limit Level exceedance was recorded for construction noise monitoring in the reporting month.
IV. Complaint Handling, Prosecution and Public Engagement.
All complaints received in the last reporting month were finalized.
One (1) noise-related complaint (i.e. 4th January 2024) and one (1) waste management-related complaint (i.e. 15th January 2024) was received in the reporting month.
The complaint cases in January 2024 are summarized in Table I.
Table I Environmental Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
4th December 2023 |
1823 |
Blocked gullies |
Investigation report was finalized on 1st February 2024. |
|
EC182_CKRCT20240103_759 |
3rd January 2024 |
1823 |
Daytime Noise |
Investigation report was finalized on 1st February 2024. |
EC183_CKRCT20240115_763 |
15th January 2024 |
1823 |
Concrete spillage |
Investigation report was finalized on 1st February 2024. |
No notification of summons and prosecutions were received in the reporting period.
No public engagement activities were conducted in the reporting period.
V. Reporting Change
Impact monitoring at M-A3/ M-N3 has been conducted by Environmental Team (HY/2019/13) since January 2024.
VI. Future Key Issues
The main works will be anticipated in the next reporting period are as follow:
Ho Man Tin1
· Underbreak scaling and smoothing works;
· Invert, lining and OHVD construction;
· Road improvement and re-surfacing work.
Yau Ma Tei
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Extension of Noise Enclosure.
Ma Tau Kok
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Cut and cover construction
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Concreting.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man Tin site surface was substantially completed. The site had been handed over to Contract No. HY/2019/13 on 30 December 2023.
The recommended mitigation measures corresponding to the main works in the next reporting period are listed as follow:
· Good relationship shall be maintained with the nearby sensitive receivers/ stakeholders which may be affected by the construction works such as providing better/ more detail information of the work nature and inform in advance of the works to the nearby residents;
· Any excavated, stockpile of dusty material or load of dusty materials on a vehicle leaving a construction site should be covered entirely by impervious sheeting;
· All construction plants / machineries should be checked / serviced on a regular basis during the courses of construction to minimize the emission of noise generation and eliminate dark smoke emission;
· All C&D materials generated should be transported and stored at temporary storage area. Suitable materials should be sorted for reuse on-site;
· Every vehicle shall be cleaned thorough at the designated wheel washing area onsite;
· Wastewater generated from drilling shall be properly collected for reuse or treated by wastewater treatment facilities before discharge;
· Provision of drip trays for equipment likely cause spillage of chemical / fuel, and provide routine maintenance;
· Erecting temporary noise barrier for noisy Powered Mechanical Equipment (PME) and deployment of Quality Powered Mechanical Equipment (QPME) as many as practicable;
· Conditions in the Environmental Permit and License should be followed;
· All recommended mitigation measures specified in the approved EIA Report and EM&A Manual shall be implemented;
· All vehicles should be cleaned before leaving the construction site to ensure no muddy deposited by them on roads.
The following EP submissions were submitted during the reporting month:
Table II Status of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A Report (December 2023) |
11 January 2024 |
Contents
1.3 Construction Programme and Activities
1.4 Works undertaken during the month
1.5 Status of Environmental Licences, Notification and Permits
2 ENVIRONMENTAL MONITORING REQUIREMENTS
2.1 Construction Dust and Noise Monitoring Locations
2.2 Construction Dust Monitoring
2.3 Construction Noise Monitoring
3 ENVIRONMENTAL MONITORING RESULTS
3.1 Construction Dust Monitoring
3.2 Construction Noise Monitoring
5 ENVIRONMENTAL COMPLAINT AND NON-COMPLIANCE
5.1 Complaint Handling, Prosecution and Public Engagement
5.2 Summary of Environmental Non-Compliance
5.3 Summary of Monitoring Exceedance
8 CONCLUSION AND RECOMMENDATIONS
Tables
Table I – Environmental Complaints Log
Table II – Status of Required Submission under Environmental Permit
Table 1.1 – Contact Information of Key Personnel
Table 1.2 – Environmental Licenses, Notification and Permits Summary
Table 2.1 – Construction Dust and Noise Monitoring Location
Table 2.3 – Construction Noise Monitoring Parameters, Frequency and Duration
Table 4.1 – Observations and Recommendation of Site Inspection in the Reporting Period
Table 5.1 – Environmental Complaints Log
Table 6.1 – Status of Required Submission under Environmental Permit
Figures
Figure 1 The Site Layout Plan of the Contract
Figure 2.1 The Location of the Construction Dust and Noise Monitoring Stations (Ho Man Tin)
Figure 2.2 The Location of the Construction Dust and Noise Monitoring Stations (Ma Tau Kok)
Figure 2.3 The Location of the Construction Dust and Noise Monitoring Stations (Yau Ma Tei)
Appendices
Appendix A Construction Programme
Appendix B Project Organization Chart
Appendix C Event and Action Plan
Appendix D Implementation Status of Environment Mitigation Measures (Construction Phase)
1.1.1 In order to meet the traffic demand and relieve traffic congestion on the existing east-west roads across Central Kowloon, Central Kowloon Route (CKR) (hereinafter referred to as “the Project”) is proposed which is a 4.7 km long dual 3-lane trunk road in Central Kowloon linking Yau Ma Tei Interchange in West Kowloon with the road network on Kai Tak Development and Kowloon Bay in East Kowloon.
1.1.2 The Central Kowloon Route – Design and Construction Environmental Impact Assessment Report (Register No.: AEIAR-171/2013) was approved with conditions by the Environmental Protection Department (EPD) on 11 July 2013. An Environmental Permit (EP-457/2013) was issued on 9 August 2013. A variation of EP (VEP-594/2021) was applied on 26 May 2021 and the latest EP (EP-457/2013/D) was issued by EPD on 15 June 2021.
1.1.3 Contract No. HY/2018/08 Central Kowloon Route – Central Tunnel (hereinafter referred to as “the Contract”), is one of the contracts of CKR which included the construction of the central tunnel, cut-and-cover tunnels at Yau Ma Tei and Ma Tau Kok and construction of piles and diaphragm walls for Ho Man Tin ventilation building.
1.1.4 Fugro Technical Services Limited (FTS) was appointed by Bouygues Travaux Publics (BTP) as the Environmental Team (ET) under the Contract no. HY/2018/08 to execute the environmental monitoring and audit (EM&A) programme under the issued EP (EP No.: EP-457/2013/D) and in accordance with the EM&A Manual.
1.1.5 This is the 53rd Monthly
EM&A Report prepared by FTS for the Contract No. HY/2018/08 Central Kowloon
Route – Central Tunnel. The Contract No. HY/2018/08 commenced on 19 September
2019. This report summarized the monitoring results and audits findings of the
EM&A programme under the issued EP (EP No.: EP-457/2013/D) and in
accordance with the EM&A Manual during the reporting period from 01/01/2024
to 31/01/2024.
1.2.1 The Project Organization structure is shown in Appendix B. The key personnel contact names and numbers are summarized in Table 1.1.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Highways Department (HyD) |
E13/CKR |
Mr. Joe Lam |
2762 3380 |
Arup-Mott MacDonald Joint Venture (AMMJV) |
Senior Resident Engineer |
Mr. Ben Poon |
3619 5967 |
ERM-Hong Kong, Limited (ERM) |
Independent Environmental Checker (IEC) |
Ms. Mandy To |
2271 3000 |
Bouygues Travaux Publics (BTP) |
Environmental Manager |
Mr. Simon Wong |
9281 4346 |
Fugro Technical Services Limited |
ET Leader |
Mr. Calvin Leung |
3565 4441 |
1.3 Construction Programme and Activities
1.3.1 The construction phase of this Contract under the EP commenced in October 2019. The site layout plan of the Contract is shown in Figure 1.
1.3.2 The construction programme of this Contract is shown in Appendix A.
1.4 Works undertaken during the month
1.4.1 The main construction works carried out in the reporting period were as follow:
· Underbreak scaling and smoothing works;
· Invert, lining and OHVD construction;
· CLP Room demolition and slope reinstatement.
Yau Ma Tei
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work.
Ma Tau Kok
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Cut and cover construction
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Concreting.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man Tin site surface was substantially completed. The site had been handed over to Contract No. HY/2019/13 on 30 December 2023.
1.5 Status of Environmental Licences, Notification and Permits
1.5.1 A summary of the relevant permits, licenses and/or notifications on environmental protection for this Contract is presented in Table 1.2.
Table 1.2 Environmental Licenses, Notification and Permits Summary
Reference No |
Valid From |
Valid Till |
|
Form NB |
448930, 448970, 448971 |
Mid-Sep 2019 |
NA |
Billing Account for Disposal of C&D waste |
Account no. 7034790 |
06 Aug 2019 |
NA |
Chemical Waste Producer Registration (Ho Man Tin Construction site) |
5111-236-B2557-02 |
25 Sep 2019 |
NA |
Chemical Waste Producer Registration (Yau Ma Tei Construction site) |
5213-225-B2557-05 |
19 Apr 2021 |
NA |
Chemical Waste Producer Registration (Ma Tau Kok Construction site) |
5213-247-B2557-06 |
19 Apr 2021 |
NA |
Construction Noise Permit |
|||
Construction Noise Permit (Ho Man Tin Construction site) |
GW-RE1416-23 |
14 Nov 2023 |
13 Jan 2024 |
Construction Noise Permit (Ho Man Tin Construction site)1 |
GW-RE0005-24 |
14 Jan 2024 |
13 Mar 2024 |
Construction Noise Permit (Yau Ma Tei Construction site) |
GW-RE1281-23 |
13 Oct 2023 |
12 Jan 2024 |
Construction Noise Permit (Yau Ma Tei Construction site)2 |
GW-RE0015-24 |
13 Jan 2023 |
12 Apr 2024 |
Construction Noise Permit (Yau Ma Tei Construction site) |
GW-RE1606-23 |
23 Dec 2023 |
22 Mar 2024 |
Construction Noise Permit (Ma Tau Kok Construction site) |
GW-RE1336-23 |
04 Nov 2023 |
03 Feb 2024 |
Construction Noise Permit (Ma Tau Kok Construction site) |
GW-RE1547-23 |
18 Dec 2023 |
17 Feb 2024 |
Construction Noise Permit (Kai Tak Barging Point) |
GW-RE0547-23 |
01 Jun 2023 |
30 Nov 2023 |
Construction Noise Permit (Kai Tak Barging Point) |
GW-RE1526-23 |
01 Dec 2023 |
29 Apr 2024 |
Construction Noise Permit (Sheung Lok Street) |
GW-RE1422-23 |
14 Nov 2023 |
13 Mar 2024 |
Water Discharge License |
|||
Water Discharge License
|
WT00034873-2019 (Ho Man Tin Construction site) |
22 Nov 2019 |
30 Nov 2024 |
WT00035436-2019 (Portion 18) |
02 Apr 2020 |
30 Apr 2025 |
|
WT00037723-2021 (Yau Ma Tei Construction site) |
07 Apr 2021 |
30 Apr 2026 |
|
WT00037883-2021 (Ma Tau Kok Construction site) |
30 Apr 2021 |
30 Apr 2026 |
|
WT00042304-2022 (Sheung Lok Street) |
13 Oct 2022 |
31 Oct 2027 |
|
WT10001427-20233 (Ma Hang Chung Road) |
4 Dec 2023 |
31 Dec 2028 |
Notes:
1 GW-RE1416-23 was superseded by GW-RE0005-24 since 14 January 2024.
2 GW-RE1281-23 was superseded by GW-RE0015-24 since 13 January 2024.
2 ENVIRONMENTAL MONITORING REQUIREMENTS
2.1 Construction Dust and Noise Monitoring Locations
2.1.1 Three construction dust monitoring locations and five construction noise monitoring locations pertinent to the Project have been identified based on the approved EM&A Manual for the Project. The locations of the construction dust and noise monitoring stations are summarized in Table 2.1 as displayed in Figures 2.1 - 2.3.
Table 2.1 Construction Dust and Noise Monitoring Locations
Dust Monitoring Station ID |
Noise Monitoring Station ID |
Monitoring Location |
M-A3 |
M-N3 |
SKH Tsoi Kung Po Secondary School |
/ |
E-N12a |
19 Hing Yan Street |
E-A14a |
E-N21a |
Block B of Merit Industrial Centre |
W-A6 |
/ |
Man Cheong building |
/ |
W-N18 |
Hydan Place |
/ |
W-N25A |
Prosperous Garden Block 1 |
Notes:
1. The dust and noise monitoring stations proposed in the EM&A Manual for M-A6/ M-N6 (i.e. Ko Fai House, Kwun Fai Court) was not available for impact dust and noise monitoring, therefore impact monitoring was conducted at M-A3/ M-N3 as an alternative which was agreed by the ER, IEC and EPD;
2. The noise monitoring station proposed in the EM&A Manual for E-N12 (i.e. Grand Waterfront Tower 3) was not available for impact dust and noise monitoring, therefore impact monitoring was conducted at E-N12a as an alternative which was agreed by the ER, IEC and EPD;
3. The dust and noise monitoring stations proposed in the EM&A Manual for E-A14 (i.e. Wyler Gardens) and E-N21 (i.e Hang Chien Court Block J) was not available for impact dust and noise monitoring, therefore impact monitoring was conducted at E-A14a/ E-N21a as an alternative which was agreed by the ER, IEC and EPD;
4. The dust monitoring stations proposed in the EM&A Manual for W-A5 (i.e. The Coronation) was not available for impact dust monitoring, therefore impact monitoring was conducted at W-A6 as an alternative which was agreed by the ER, IEC and EPD.
2.1.2 The last impact monitoring conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was subsequently conducted by Environmental Team of Contract HY/2019/13 since January 2024 (Figure 2.1).
2.1.3 The construction dust and noise monitoring locations at M-A3 and M-N3 are covered by Contract No. HY/2019/13 Central Kowloon Route – Buildings, Electrical and Mechanical Works. The monitoring results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared by Contract No. HY/2019/13.
2.1.4 The construction dust and noise monitoring locations at E-A14a, E-N12a and E-N21a are now covered by Contract No. HY/2014/07 Central Kowloon Route – Kai Tak West. The monitoring results at E-A14a, E-N12a and E-N21a in the reporting month are presented in the monthly EM&A Report prepared by Contract No. HY/2014/07.
2.1.5 The construction dust and noise monitoring locations at W-A6, W-N18 and W-N25A are now covered by Contract No. HY/2014/08 Central Kowloon Route –Yau Ma Tei East. The monitoring results at W-A6, W-N18 and W-N25A in the reporting month are presented in the monthly EM&A Report prepared by Contract No. HY/2014/08.
2.2 Construction Dust Monitoring
Monitoring Requirement
2.2.1 In accordance with the approved EM&A Manual, 1-hour and 24-hour Total Suspended Particulates (TSP) levels should be measured at the designated air quality monitoring stations to indicate the impacts of construction dust on air quality. Regular Impact 24-hour TSP monitoring should be carried out for at least once every 6 days, and 1-hour TSP monitoring should be done at least 3 times every 6 days when the highest dust impact occurs.
Monitoring Equipment
2.2.2 24-hour TSP air quality monitoring was performed using High Volume Sampler (HVS) deployed at the designated monitoring station. The HVS shall meet all the requirements of the EM&A Manual.
2.2.3 A portable direct reading dust meter was used to carry out the 1-hour TSP monitoring.
2.3 Construction Noise Monitoring
Monitoring Requirement
2.3.1 In accordance with the EM&A Manual, impact noise monitoring should be conducted at the designated noise monitoring stations for at least once a week during the construction phase of the Project. The parameters, frequency and duration of impact noise monitoring is summarized in Table 2.3.
Table 2.3 Construction Noise Monitoring Parameters, Frequency and Duration
Parameter |
Duration |
Frequency |
A-weighted equivalent continuous sound pressure level (Leq). L10 and L90 were also recorded |
30 minutes |
At least once per week |
Monitoring Equipment
2.3.2 Noise monitoring was performed using sound level meter at the designated monitoring station. The sound level meters deployed comply with the International Electrotechnical Commission Publications 651:1979 (Type 1) and 804:1985 (Type 1) specifications. Acoustic calibrator was deployed to check the sound level meters at a known sound pressure level.
2.4.1 As per the EM&A Manual, the landscape and visual mitigation measures shall be implemented and site inspections should be undertaken once every two weeks during the construction period. A summary of the implementation status is presented in Section 4.
3 ENVIRONMENTAL MONITORING RESULTS
3.1 Construction Dust Monitoring
3.1.1 The last impact monitoring conducted by ET of Contract HY/2018/08 was on 27 December 2023. Impact monitoring at M-A3 was subsequently conducted by Environmental Team of Contract HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared by Contract No. HY/2019/13.
3.1.2 No Action and Limit Level exceedance was recorded for construction dust monitoring in the reporting month.
3.2 Construction Noise Monitoring
3.2.1 The last impact monitoring conducted by ET of Contract HY/2018/08 was on 27 December 2023. Impact monitoring at M-N3 was subsequently conducted by Environmental Team of Contract HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared by Contract No. HY/2019/13.
3.2.2 One (1) Action Level exceedance was recorded for construction noise due to the noise-related complaints received in the reporting month. No Limit Level exceedance was recorded for construction noise monitoring in the reporting month.
3.3.1 Auditing of waste management practices during regular site inspections confirmed that the waste generated during construction were properly, stored, handled and disposed of in general. The Contractor was responsible for the implementation of any mitigation measures to reduce waste or redress issues arising from the waste materials.
3.3.2 The implemented environmental mitigation measures for the waste management in the reporting period are summarized in Appendix D. The summary of observations and recommendations made for waste management during the site inspections are presented in Table 4.1.
3.3.3 Monthly summary of waste flow table is detailed in Appendix F.
3.4.1 Bi-weekly inspections of the implementation of landscape and visual mitigation measures were conducted on 2 and 16 January 2024. The implementation the landscape and visual mitigation measures in the reporting period are summarized in Appendix D. The summary of observations and recommendations made for landscape and visual mitigation measures during the site inspections are presented in Table 4.1.
3.4.2 The Event and Action Plan for landscape and visual during construction phase is given in Appendix C.
4 ENVIRONMENTAL SITE INSPECTION AND AUDIT
4.1.1 Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures for the Project. A summary of the mitigation measures implementation status is provided in Appendix D.
4.1.2 In the reporting month, five site inspections were carried out on 2, 9 (with IEC), 16, 23 and 30 January 2024. Details of observations recorded during the site inspections are presented in Table 4.1.
Table 4.1 Observations and Recommendation of Site Inspection in the Reporting Period
Environmental Aspect |
Date |
Observations and Recommendations |
Follow-up Actions |
Air Quality |
Nil |
Nil |
Nil |
Nil |
Nil |
Nil |
|
Noise |
Nil |
Nil |
Nil |
Water Quality |
Nil |
Nil |
Nil |
Waste Management |
2 Jan 2024 |
The Contractor was reminded to regularly clear up the construction waste to prevent accumulation. |
Construction waste was removed from construction site. |
Landscape and Visual |
Nil |
Nil |
Nil |
Permit/ Licenses |
Nil |
Nil |
Nil |
5 ENVIRONMENTAL COMPLAINT AND NON-COMPLIANCE
5.1 Complaint Handling, Prosecution and Public Engagement
5.1.1 All complaints received in the last reporting month were finalized.
5.1.2 One (1) noise quality-related complaint (i.e. 3rd January 2024) and one (1) waste management-related complaint (i.e. 15th January 2024) was received in the reporting month.
5.1.3 The complaint cases in January 2024 are summarized in Table 5.1.
Table 5.1 Environmental Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
EC181_CKRCT20231204_755 |
4th December 2023 |
1823 |
Blocked gullies |
Investigation report was finalized on 1st February 2024. |
EC182_CKRCT20240103_759 |
3rd January 2024 |
1823 |
Daytime Noise |
Investigation report was finalized on 1st February 2024. |
EC183_CKRCT20240115_763 |
15th January 2024 |
1823 |
Concrete spillage |
Investigation report was finalized on 1st February 2024. |
5.1.4 Cumulative complaint log, summaries of complaints, notification of summons and successful prosecutions are presented in Appendix E.
5.1.5 No public engagement activities were conducted in the reporting period.
5.2 Summary of Environmental Non-Compliance
5.2.1 A waste management related observation was recorded during the site inspection on 2nd Jan 2024. The observation was rectified by Contractor on 5th Jan 2024.
5.3 Summary of Monitoring Exceedance
5.3.1 The last impact monitoring conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was subsequently conducted by Environmental Team of Contract HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared by Contract No. HY/2019/13.
5.3.2 No Action and Limit Level exceedance was recorded for construction dust monitoring in the reporting month.
5.3.3 One (1) Action Level exceedance was recorded for construction noise due to the noise-related complaints received in the reporting month. No Limit Level exceedance was recorded for construction noise monitoring in the reporting month.
6 IMPLEMENTATION STATUS OF ENVIRONMENTAL MITIGATION MEASURE
6.1.1 The Contractor had implemented environmental mitigation measures and requirements as stated in the EIA Report, the EP and EM&A Manual. The implementation status of the environmental mitigation measures during the reporting period is summarized in Appendix D. Status of required submissions under the EP during the reporting period is summarised in Table 6.1.
Table 6.1 Status of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A Report (December 2023) |
11 January 2024 |
7.1.1 The main works will be anticipated in the next reporting period are as follow:
Ho Man Tin1
· Underbreak scaling and smoothing works;
· Invert, lining and OHVD construction;
· Road improvement and re-surfacing work.
Yau Ma Tei
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Extension of Noise Enclosure.
Ma Tau Kok
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Cut and cover construction
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Concreting.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man Tin site surface was substantially completed. The site had been handed over to Contract No. HY/2019/13 on 30 December 2023.
7.1.2 The recommended mitigation measures corresponding to the main works in the next reporting period are listed as follows:
· Good relationship shall be maintained with the nearby sensitive receivers/ stakeholders which may be affected by the construction works such as providing better/ more detail information of the work nature and inform in advance of the works to the nearby residents;
· Any excavated, stockpile of dusty material or load of dusty materials on a vehicle leaving a construction site should be covered entirely by impervious sheeting;
· All construction plants / machineries should be checked / serviced on a regular basis during the courses of construction to minimize the emission of noise generation and eliminate dark smoke emission;
· All C&D materials generated should be transported and stored at temporary storage area. Suitable materials should be sorted for reuse on-site;
· Every vehicle shall be cleaned thorough at the designated wheel washing area onsite;
· Wastewater generated from drilling shall be properly collected for reuse or treated by wastewater treatment facilities before discharge;
· Provision of drip trays for equipment likely cause spillage of chemical / fuel, and provide routine maintenance;
· Erecting temporary noise barrier for noisy Powered Mechanical Equipment (PME) and deployment of Quality Powered Mechanical Equipment (QPME) as many as practicable;
· Conditions in the Environmental Permit and License should be followed;
· All recommended mitigation measures specified in the approved EIA Report and EM&A Manual shall be implemented.
· All vehicles should be cleaned before leaving the construction site to ensure no muddy deposited by them on roads.
8 CONCLUSION AND RECOMMENDATIONS
8.1.1 The 53rd Monthly EM&A Report for the Contract No. HY/2018/08 Central Kowloon Route – Central Tunnel summarized the monitoring results and audits findings of the EM&A programme under the issued EP (EP No.: EP-457/2013/D) and in accordance with the EM&A Manual during the reporting period from 01/01/2024 to 31/01/2024.
8.1.2 No construction noise monitoring was conducted in the reporting month as the site had been handed over to Contract No. HY/2019/13 on 30 December 2023. Impact monitoring at M-A3/ M-N3 has been conducted by Environmental Team (HY/2019/13) since January 2024.
8.1.3 One (1) Action Level exceedance was recorded for construction noise due to the noise-related complaints received in the reporting month. No Limit Level exceedance was recorded for construction noise monitoring in the reporting month. No Action and Limit Level exceedance was recorded for construction dust monitoring in the reporting month.
8.1.4 Weekly environmental site inspections were conducted during the reporting period. In general, the Contractor had implemented environmental mitigation measures and requirements as stated in the EIA Report, the EP and EM&A Manual.
8.1.5 All complaints received in the last reporting month were finalized.
8.1.6 One (1) noise-related complaint (i.e. 3rd January 2024) and one (1) waste management-related complaint (i.e. 15th January 2024) was received in the reporting month. Both complaints were finalized and settled.
8.1.7 No environmental related prosecutions or notification of summons were received in the reporting period.
8.1.8 A waste management related observation was recorded during the site inspection on 2nd Jan 2024. The observation was rectified by Contractor on 5th Jan 2024.
8.1.9 According to the environmental site inspections performed in the reporting month, the following recommendations were provided:
Air Quality Impact
· No specific observation was identified in the reporting month.
Construction Noise Impact
· No specific observation was identified in the reporting month.
Water Quality Impact
· No specific observation was identified in the reporting month.
Waste Management
· No specific observation was identified in the reporting month.
Landscape and Visual Impact
· No specific observation was identified in the reporting month.
Permit/ Licenses
· No specific observation was identified in the reporting month.
